The JIRA Cutoff Date is a feature within the JIRA for Forecast integration. It allows users to restrict the synchronization of JIRA data with Forecast based on a certain date defined in the project's sync settings.
This article contains
- How to set a JIRA Cutoff Date
- Removing a JIRA Cutoff Date
- Synchronization Rules
- Date changes made in JIRA
How to set a Cutoff Date
JIRA Cutoff Date may be defined when initially configuring a project's sync with JIRA. It is also possible to update an existing project sync's settings to add or change a JIRA Cutoff Date. To learn more about how to sync projects with JIRA see, Syncing JIRA projects to Forecast projects.
To add a JIRA Cutoff Date during sync setup
- Open the project.
- Click Settings in the left side panel.
- Select Integrations.
- Select Sync to Jira project or Sync to Jira epics.
- Find the setting Synchronize the JIRA items from a specific day onward.
- Toggle Yes.

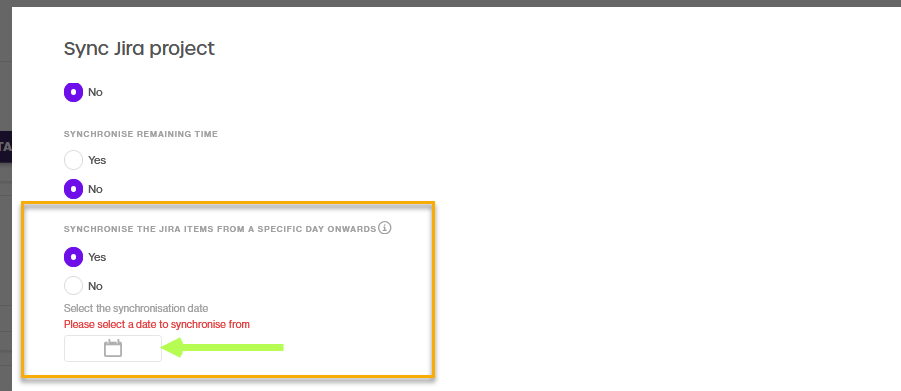

- In the Calendar, select the date to synchronize from. This is the JIRA Cutoff Date.
To add a JIRA Cutoff Date on an existing JIRA-synced project
- Open the project.
- Click Settings in the left side panel.
- Select Integrations.
- The existing sync settings will display.

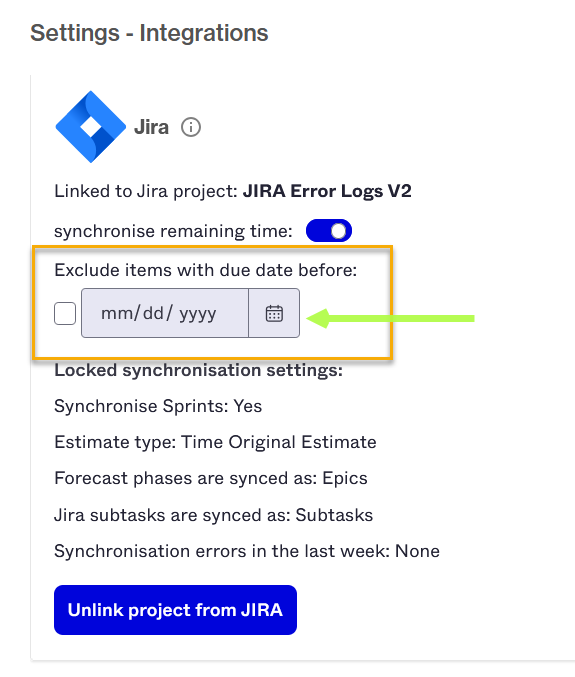

- Find the setting Exclude items with a due date before.

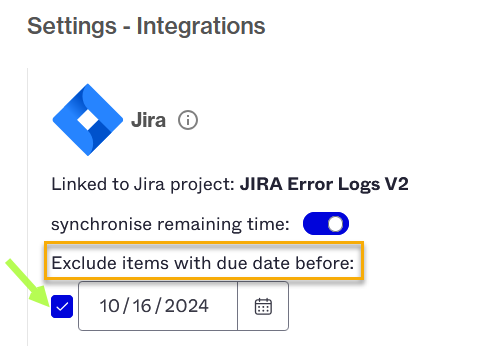

- In the date field, enter the numerical values for MM/DD/YYYY or click on the calendar and select a date. This is the JIRA Cutoff date.

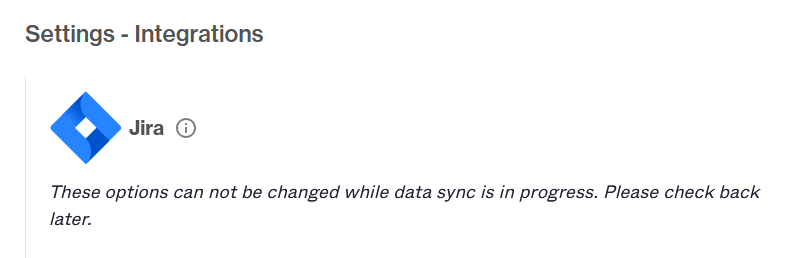

- While the sync is updating the following message will appear. Once the sync updates are complete the message will no longer appear.
Removing a JIRA Cutoff Date
It is possible to remove a JIRA Cutoff Date in projects synced with JIRA projects or epics. Removing a JIRA Cutoff Date will result in all JIRA issues and worklogs syncing from JIRA to Forecast regardless of their dates.
To remove a JIRA Cutoff Date
- Open the project.
- Click Settings in the left side panel.
- Select Integrations.
- In the JIRA sync settings, untick the box under the setting Exclude items with a due date before.

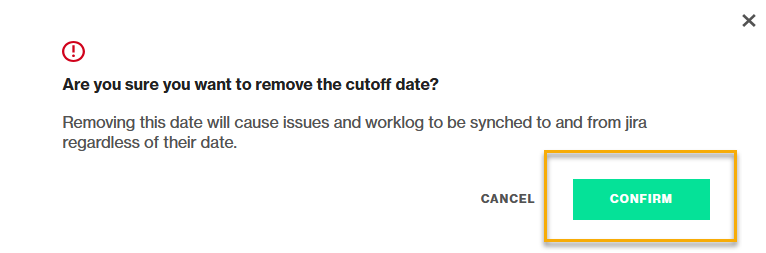

- Review the warning and confirm to complete the action to remove the JIRA Cutoff Date.
- While the sync is updating the following message will appear. Once the sync updates are complete the message will no longer appear.
Synchronization Rules
The following rules apply to the JIRA Cutoff Date within Forecast projects synced with JIRA projects or epics.
Issues
Issue Types: Epic, Story, Task, Subtask will sync to Forecast if:
- They have no due date
- Their due date is on or after the JIRA Cutoff Date.
- JIRA child issues will sync if their JIRA parent issue is synced.
- If a JIRA child issue's parent issue has a due date occurring before the cutoff date, the sub-task will not be synced to Forecast even if its own due date is after the cutoff date.
Versions
If the project is set up to sync versions as phases in Forecast, then versions will sync to Forecast if:
- They have no end date
- Their end date is on or after the cutoff date.
Sprints
If the project is set up to sync sprints, then sprints will sync to Forecast if:
- They have no end date
- Their end date is on or after the cutoff date.
Worklogs
JIRA worklogs are synced to Forecast if:
- Their date is on or after the cutoff date.
Date changes made in JIRA
Date changes made in JIRA will be respected by the JIRA Cutoff Date and determine if the sync will include or exclude the item.
- If an item in JIRA is changed so that it no longer lies within the cutoff date it will be removed during the overnight sync process.
- If an item in JIRA is changed to be within the cutoff date, it may appear immediately. If it does not, it will be updated and appear in Forecast during the overnight sync process.
